Verdict: 4-inch fiber-reinforced, 6% air-entrained concrete over a 10-inch base - or no embedded cable
A heated slab is only as durable as the concrete around the cable. The specification calls for a 4-inch minimum pour, fibre-reinforced, with a 6% air-entrained mix. A standard 3,000 psi gravel mix with no air entrainment cracks and spalls in 10 to 15 years in a freeze-thaw climate, which puts the slab's failure well inside the driveable life of the driveway and takes 30-to-50-year heating cable down with it. This is not a contractor preference. It is the difference between a 10-year slab and a 30-year slab.
Air entrainment: the additive that decides the outcome
Concrete is porous. Water seeps into those pores, and when it freezes it expands by about 9%, fracturing the matrix from within. Repeated through a Midwest freeze-thaw winter, that produces progressive cracking, pitting and spalling. Road salt makes it worse: it melts ice temporarily while creating a highly corrosive brine that accelerates deep pitting and surface scaling on the finished surface.
Air-entraining agents introduce microscopic air pockets throughout the mix. Those pockets give expanding ice somewhere to push instead of cracking the surrounding concrete. Combined with fiber reinforcement, the documented effect is a service life extending up to 30 years against 10 to 15 for a standard slab.
| Mix | Service life in a freeze-thaw climate | Verdict where cable is embedded |
|---|---|---|
| Standard 3,000 psi gravel mix, no air entrainment | 10-15 years before cracking and spalling | Reject - the slab fails before the cable does |
| 4,500 psi exterior winter mix, air-entrained | The brief's baseline for outdoor slabs in hard frost | Minimum acceptable |
| 4 in. min., fiber-reinforced, 6% air-entrained | Up to 30 years | The specified build for embedded cable |
| High-early-strength mix with accelerators | 70% of design strength at day 3 instead of 45% | Only to shorten cold-weather access restrictions |
Fibre, rebar and welded wire mesh: three different jobs
Reinforcement in a heated slab does three things, and only the first is structural: it carries vehicle loads, it holds the concrete together after cracking, and it keeps the heating cable at the correct depth while the pour is placed and finished. That third job is specific to a heated driveway, and it is why fibres in the mix and a wire mesh in the slab are used together rather than as substitutes.
| Reinforcement | Unit weight or coverage | Spacing | Role in a heated slab |
|---|---|---|---|
| Fibres in the mix | Part of the 4 in. winter mix | n/a | Crack-width control through freeze-thaw cycling |
| #4 rebar (1/2 in.) | 0.668 lb per linear foot | 12 in. heavy load, 16 in. residential | Load carrying; keep clear of the heating elements |
| #3 rebar (3/8 in.) | 0.376 lb per linear foot | 16 in. standard, 18 in. light | Light residential grid |
| Welded wire mesh 6x6 | 5 x 10 ft sheet = 50 sq ft, about 15 lb per sheet; order sheets x 1.15 for laps | Sheets lapped | The armature the cable ties to; useless if trodden to the base |
Mesh earns its place for a reason unrelated to bending strength: it is what the cable is tied to, and it must be elevated roughly 2 inches off the subgrade on plastic spacers so the cable finishes mid-slab, where it belongs thermally. If finishers walk the mesh down to the aggregate, the cable sinks with it and surface heat is lost. Ask how the mesh will be elevated, and treat "we'll hook it up during the pour"
Order the reinforcement by weight rather than by feel. On the 20 x 20 ft slab used throughout this pack, a 16-inch #4 rebar grid needs about 600 linear feet of bar - fifteen bars each way at 20 ft - which at 0.668 lb per foot is roughly 400 lb of steel before laps. Welded wire mesh is priced differently: a 5 x 10 ft sheet covers 50 sq ft, so a 400 sq ft slab needs nine sheets once the 1.15 lap factor is applied, about 135 lb of mesh at roughly $18 a sheet. Fibres are a mix-design line item rather than a separate purchase. The cable is tied to that mesh, which is the reason the mesh quantity is not negotiable even though a slab on a compacted base carries very little bending load.
Joints: what protects the cable and what voids the warranty
Heating cable must never run through or cross a full-depth expansion joint. Slabs move independently, and a cable spanning the gap carries the full shear until it snaps. Two compliant methods exist. The preferred approach is to pre-mark every planned expansion joint on the compacted base and give each slab its own independent cable run that stops clear of the joint. Where a crossing is unavoidable, a 2 in. x 2 in. downward bend or loop of cable into the subgrade puts slack below the reach of a concrete saw blade and lets the slabs move without shearing the conductor.
Shallow control joints are a different case: cable may pass beneath a saw-cut stress line provided it sits at the proper 2 to 3 inch depth, below the blade. A contractor who proposes cutting a slot through the expansion board to feed cable through has voided the 10-year manufacturer warranty in writing.
Curing decides whether you get the mix you paid for
Strength develops after the pour, not at it. The site's curing model tracks the hydration curve and the traffic restrictions that accompany it. Skipping curing compound or the wet-cover period is not a scheduling shortcut on a slab you intend to shovel and salt for three decades; it is a permanent loss of surface strength and abrasion resistance.
| Day | Standard mix (50-75°F) | Cold pour (below 50°F) | High-early mix | Access permitted |
|---|---|---|---|---|
| Day 1 | 20% | 15% | 40% | Foot traffic only, blankets kept wet |
| Day 3 | 45% | 30% | 70% | Pedestrian safe |
| Day 7 | 75% | 55% | 90% | Passenger cars on day 7 only |
| Day 14 | 90% | 80% | 98% | Light vehicles, no heavy equipment |
| Day 28+ | 100%+ | 100% | 100% | Fully cured; heavy trailers and equipment |
Cold weather is the trap locally. Below 50°F the curve is retarded: day 7 reaches 55% rather than 75%, and day 14 only 80%. A late-season pour behaves like a day-14 slab on day 7, so keep the blankets on and
A cold pour is a cost trade, not a rule. Below 50°F the standard mix reaches 55% strength at day 7 and 80% at day 14, stretching the window in which the driveway cannot take a delivery van. A high-early-strength mix with accelerators reaches 70% at day 3 and 98% at day 14, buying back most of that lost week for an adder on the concrete price and a shorter window between discharge and finishing. Neither is free: the standard mix costs waiting, and the accelerated mix costs money plus margin for error under the trowel.
Mix and jointing checklist for the quote
- 4 in. minimum, fibre-reinforced, 6% air-entrained. Reject a plain 3,000 psi gravel mix explicitly.
- 10 in. compacted aggregate base for driveways, ASTM D 2490 gradation with No. 200 fines of 0-8%, over geotextile on clay.
- Cable or mat 1.5 to 3.0 in. below the finished surface, tied to galvanised mesh elevated about 2 in. off the base.
- Pre-mark expansion joints on the base and terminate each cable run clear of them; require the 2 in. x 2 in. subgrade loop where a crossing is unavoidable.
- A written curing plan with day 7 and day 28 access restrictions stated for the actual pour temperature.
- A de-icing plan that minimises rock salt, which creates the brine that scales finished surfaces.

Sources

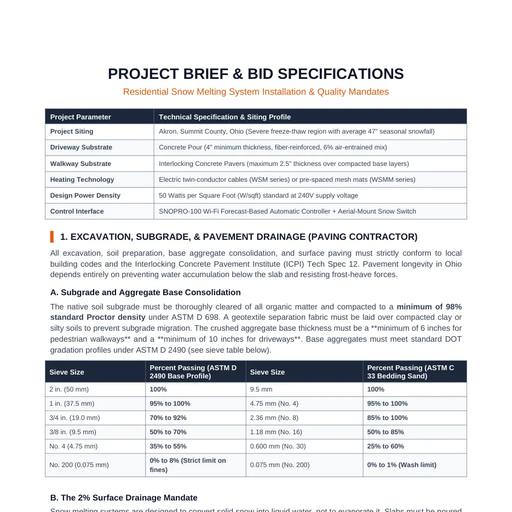

The 4-inch minimum thickness, fiber reinforcement, 6% air-entrained mix, 10-inch compacted base with ASTM D 2490 gradation, 98% Proctor subgrade compaction, geotextile requirement, the 3-inch spacing rule, the 1.5 to 3.0 inch depth window, and the expansion-joint prohibition with its 2 in. x 2 in. subgrade loop exception are from the Residential Snow Melting Project Brief & Bid Specifications (v2.0, August 2026) at /media/concrete-driveways/pdfs/heated-driveway-contractor-brief.pdf. The 10-to-15-year failure window for a standard 3,000 psi mix without air entrainment is from that brief's contractor vetting questionnaire; the 9% freeze expansion figure, the corrosive-brine effect of road salt, the statement that standard slabs last only 10 to 15 years in severe frost, and the 30-year life for fiber-reinforced air-entrained winter mixes are from the Anatomy of a Heated Driveway production script at /media/concrete-driveways/slides/. Rebar weights (0.668 and 0.376 lb per linear foot), mesh sheet coverage, lap factors, the curing percentages, the traffic-access windows and the $18 per sheet mesh price are the constants from the Concrete Paving & Driveway Calculator Development Prompts behind this site's rebar and curing calculators. The reference brief was authored for a severe freeze-thaw Ohio siting profile; the mix, reinforcement and curing figures are not location-specific, but confirm the current local code before finalising a mix design.
